Pretask
Overview
Schedule Viewing
Revision Comparison
Share and collaborate
Schedule health
Update & export
About us
Pricing

Frictionless P6 Schedule
Viewing and Collaboration

An accessible, standalone schedule collaboration tool for individuals and teams to view XERs and discuss changes in context. No P6 license required.

Sign up for waitlist
Free 30-day trialUp to 5 users · unlimited schedule revisions
Pretask.AI
Schedule Intelligence
Riverside Medical CenterRev 3
Comments 3
Save Changes
Share
Export
Search activities…
Filters
Next 2 Weeks
Data Date 07/06/2026
Today
Trace Logic
Compare
Health Check
View Setup
ID
ACTIVITY
STATUS
% COMPLETE
START
FINISH
FLOAT
Jun
Jul 2026
Aug 2026
6/29
7/6
7/13
7/20
7/27
8/3
8/10
8/17
8/24
8/31
STRUCTURE 4
Steel Erection 2
STR-1200
Erect structural steel - L4-L6
In Progress
70 %
06/15/2026
07/10/2026
0d
STR-1230
Metal deck & shear studs - L5-L6 2
In Progress
35 %
06/29/2026
07/17/2026
-2d
Decks & Concrete 2
STR-1260
Place concrete on deck - L5-L6
Not Started
0 %
07/15/2026
07/31/2026
0d
STR-1300
Steel & deck inspection
Not Started
08/03/2026
08/03/2026
+4d
ENVELOPE 6
Curtain Wall 4
ENV-2100
Curtain-wall shop-drawing approval 1
Not Started
0 %
07/13/2026
07/17/2026
+4d
ENV-2150
Install curtain wall - North face
Not Started
0 %
07/27/2026
08/28/2026
0d
ENV-2200
Install curtain wall - South face
Not Started
0 %
08/10/2026
09/11/2026
+2d
ENV-2400
Storefront glazing - Main entry
Not Started
0 %
08/24/2026
09/11/2026
+9d
Roofing & Dry-In 2
ENV-2300
Roofing membrane & insulation
Not Started
0 %
08/17/2026
09/04/2026
+12d
ENV-2350
Building dry-in
Not Started
09/11/2026
09/11/2026
0d
PROCUREMENT 3
Major Equipment 3
PRO-3100
Switchgear delivered to site 1
Not Started
07/20/2026
07/20/2026
+5d
PRO-3200
Air-handling units delivered
Not Started
08/24/2026
08/24/2026
+10d
PRO-3300
Elevator equipment delivered
Not Started
09/21/2026
09/21/2026
+15d
MEP ROUGH-IN 5
Overhead Rough-In 2
MEP-4200
Overhead MEP rough-in - Level 2
Not Started
0 %
07/27/2026
08/21/2026
0d
MEP-4250
Overhead MEP rough-in - Level 3
Not Started
0 %
08/10/2026
09/04/2026
0d
Systems & Mains 3
Schedule Intelligence

Turn your P6 XER file into a shared working view, right from your browser.

Schedule Viewing
Get answers faster

Search and filter activities, expand the WBS, inspect dates and float, and trace the logic driving any activity.  Save your views for easy access.

Learn more

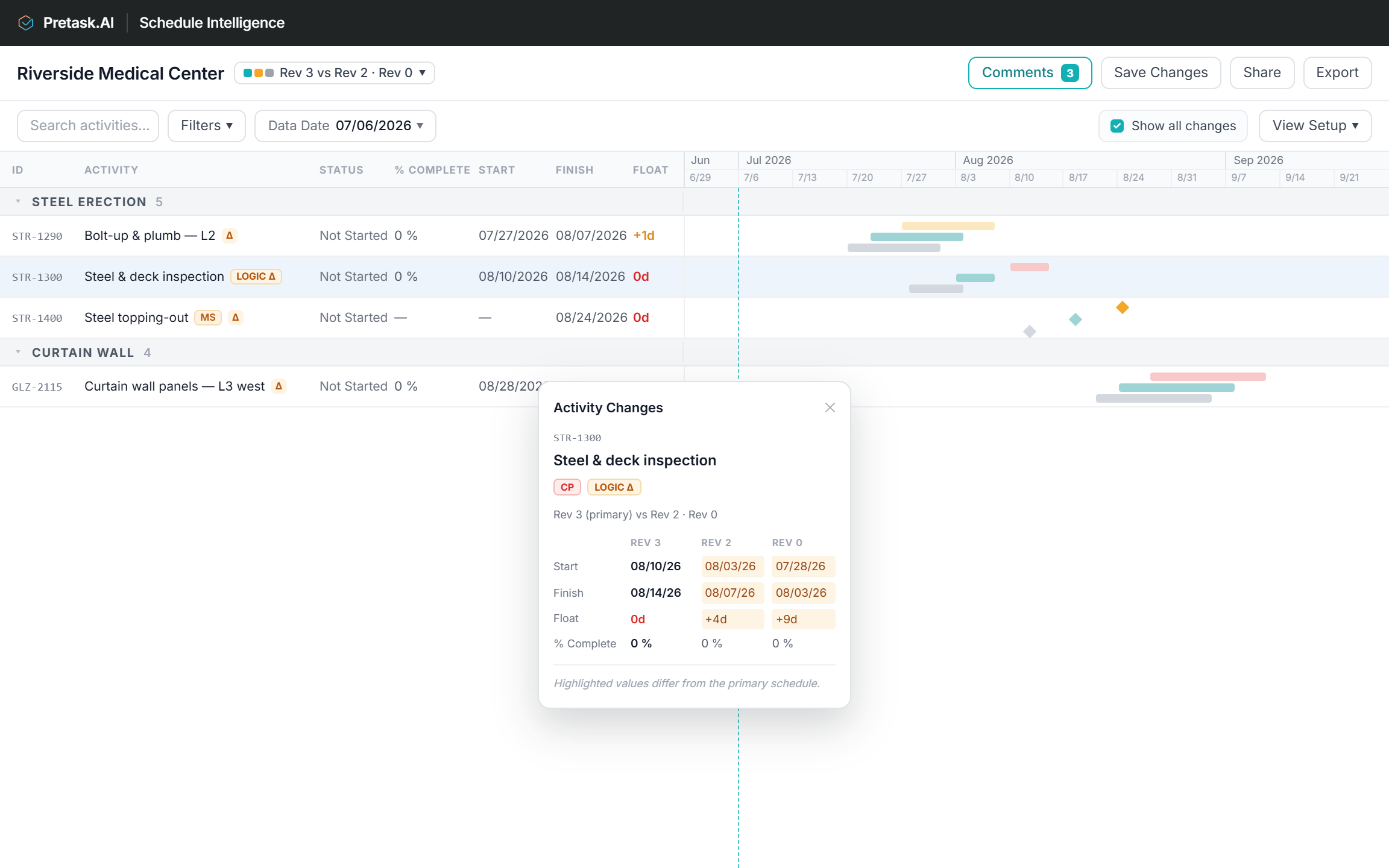

Revision Comparison
See what changed

Compare up to four schedule revisions in one Gantt. Spot date shifts, added or removed activities, and relationship changes without flipping between files.

Learn more

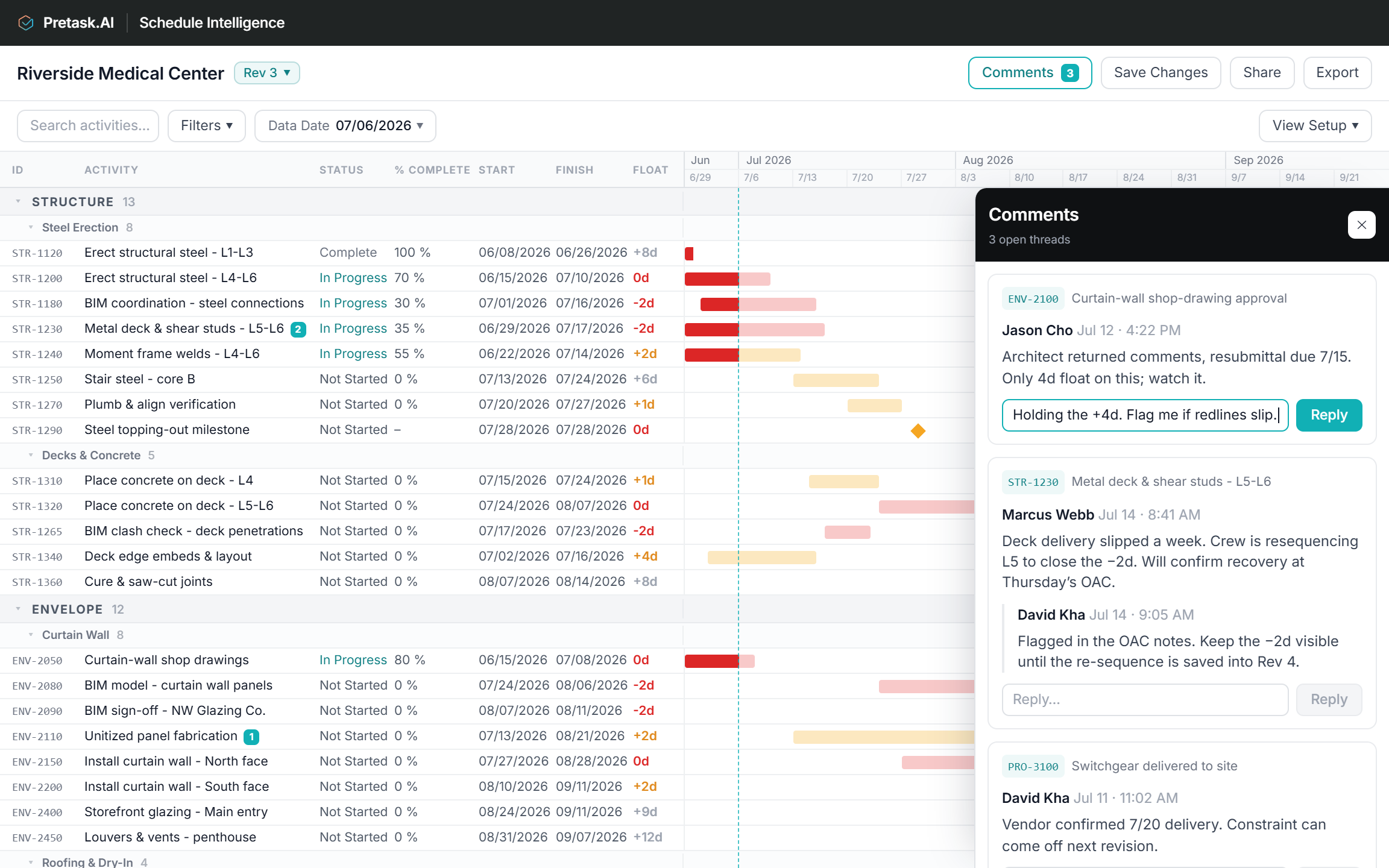

Share and collaborate
Discuss the schedule in context

Invite project partners to the same revision. Comment on an activity or WBS row, reply in thread, and keep the conversation attached to the work.

Learn more

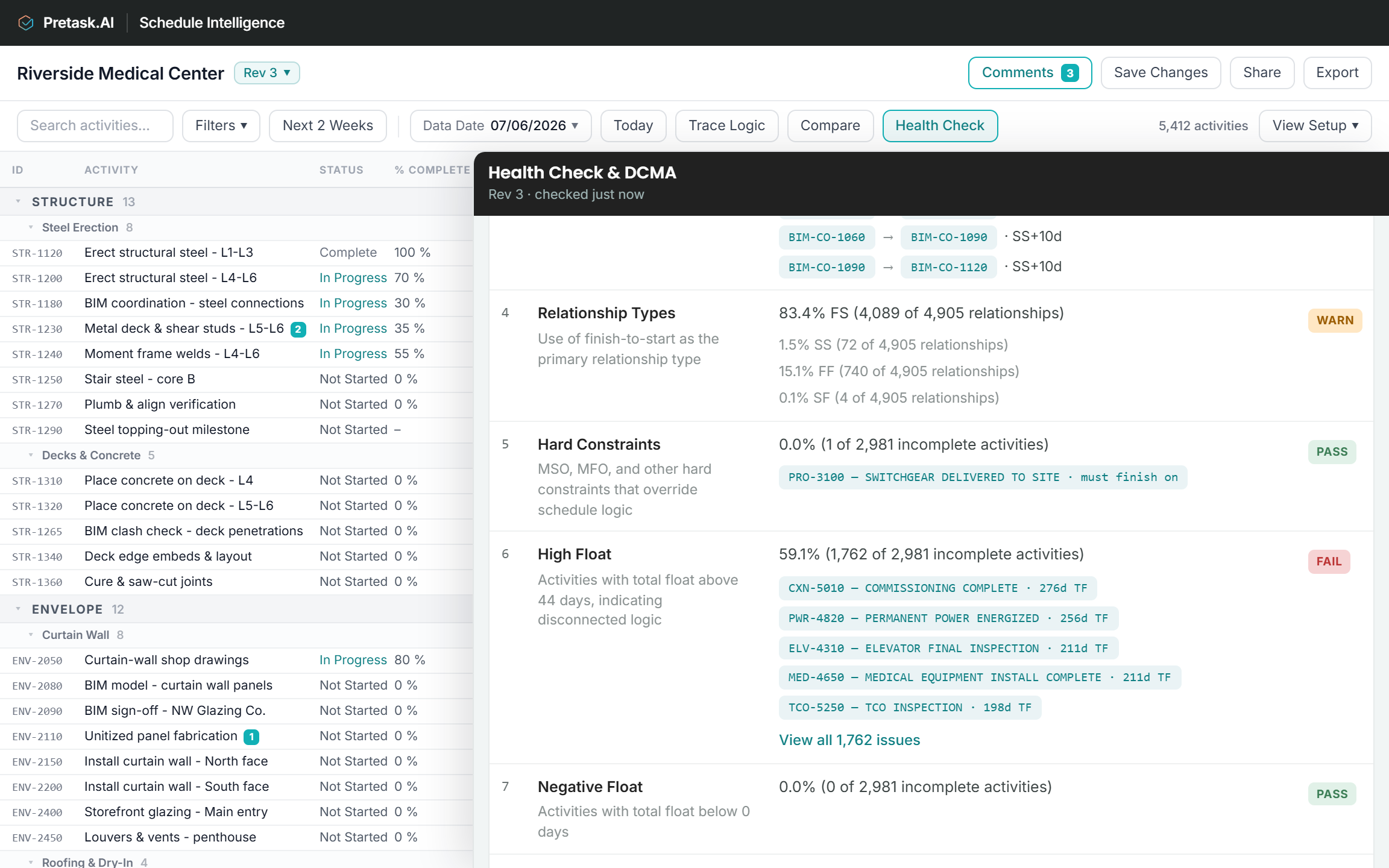

Schedule health
Know where your risks are

Run automated schedule health checks, understand what was flagged within the context of the activities.

Learn more

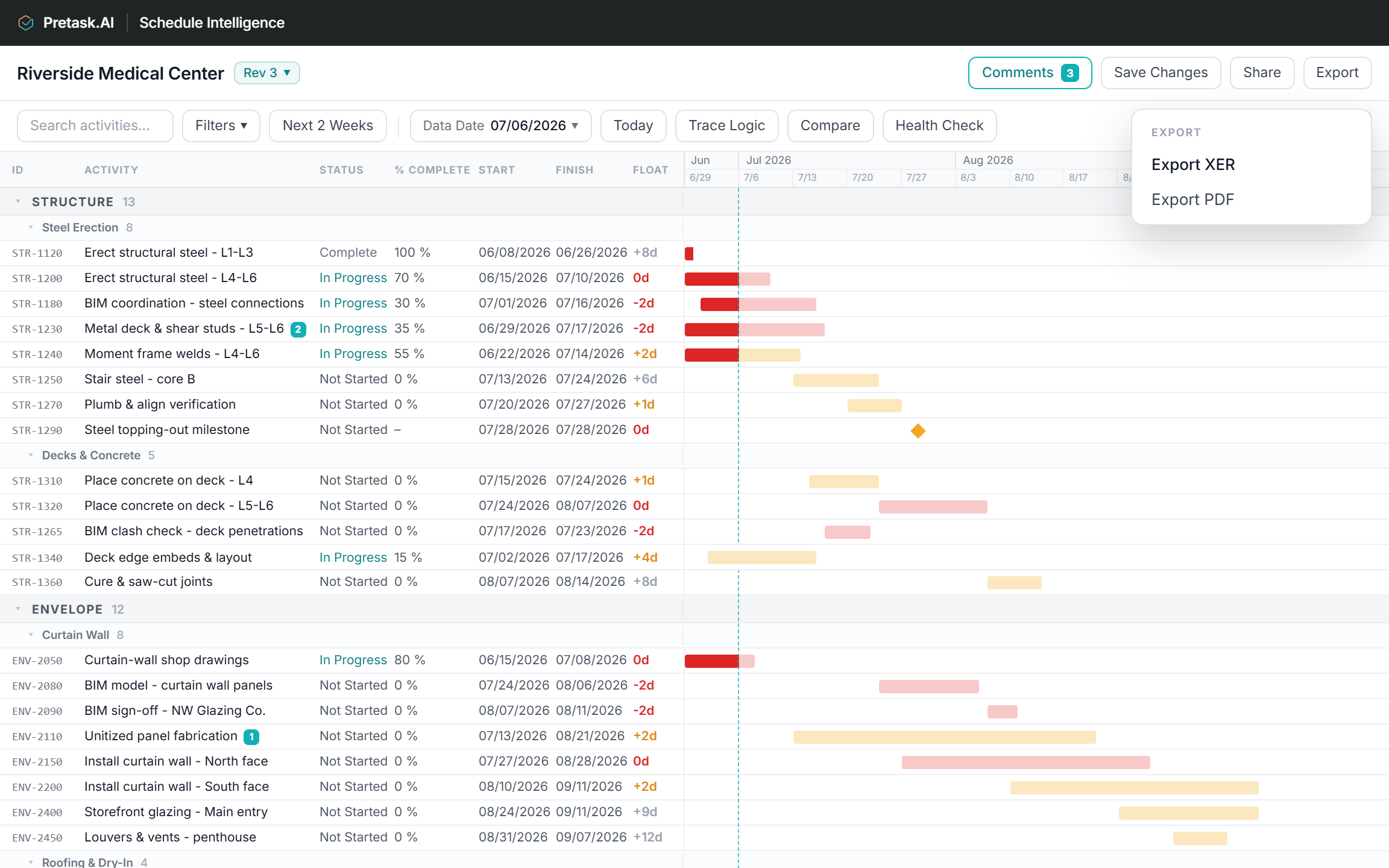

Update & export
Update progress and keep moving

Update activity status, percent complete, and actual dates. Save or create a new revision, and export an updated XER or PDF.

Learn more
Pretask.AI
Schedule Intelligence
Riverside Medical CenterRev 3
Comments 3
Save Changes
Share
Export
Search activities…
Filters
Next 2 Weeks
Data Date 07/06/2026
Today
Trace Logic
Compare
Health Check
212 activities
View Setup
ID
ACTIVITY
STATUS
% COMPLETE
START
FINISH
FLOAT
Jun
Jul 2026
Aug 2026
Sep 2026
6/29
7/6
7/13
7/20
7/27
8/3
8/10
8/17
8/24
8/31
9/7
9/14
9/21
STRUCTURE 13
Steel Erection 8
STR-1120
Erect structural steel - L1-L3
Complete
100 %
06/08/2026
06/26/2026
+8d
STR-1200
Erect structural steel - L4-L6
In Progress
70 %
06/15/2026
07/10/2026
0d
STR-1180
BIM coordination - steel connections
In Progress
30 %
07/01/2026
07/16/2026
-2d
STR-1230
Metal deck & shear studs - L5-L62
In Progress
35 %
06/29/2026
07/17/2026
-2d
STR-1240
Moment frame welds - L4-L6
In Progress
55 %
06/22/2026
07/14/2026
+2d
STR-1250
Stair steel - core B
Not Started
0 %
07/13/2026
07/24/2026
+6d
STR-1270
Plumb & align verification
Not Started
0 %
07/20/2026
07/27/2026
+1d
STR-1290
Steel topping-out milestone
Not Started
07/28/2026
07/28/2026
0d
Decks & Concrete 5
STR-1310
Place concrete on deck - L4
Not Started
0 %
07/15/2026
07/24/2026
+1d
STR-1320
Place concrete on deck - L5-L6
Not Started
0 %
07/24/2026
08/07/2026
0d
STR-1265
BIM clash check - deck penetrations
Not Started
0 %
07/17/2026
07/23/2026
-2d
STR-1340
Deck edge embeds & layout
Not Started
0 %
07/02/2026
07/16/2026
+4d
STR-1360
Cure & saw-cut joints
Not Started
0 %
08/07/2026
08/14/2026
+8d
ENVELOPE 12
Curtain Wall 8
ENV-2050
Curtain-wall shop drawings
In Progress
80 %
06/15/2026
07/08/2026
0d
ENV-2080
BIM model - curtain wall panels
Not Started
0 %
07/24/2026
08/06/2026
-2d
ENV-2090
BIM sign-off - NW Glazing Co.
Not Started
0 %
08/07/2026
08/11/2026
-2d
ENV-2110
Unitized panel fabrication1
Not Started
0 %
07/13/2026
08/21/2026
+2d
ENV-2150
Install curtain wall - North face
Not Started
0 %
07/27/2026
08/28/2026
0d
ENV-2200
Install curtain wall - South face
Not Started
0 %
08/10/2026
09/11/2026
+2d
ENV-2400
Storefront glazing - Main entry
Not Started
0 %
08/24/2026
09/11/2026
+9d
ENV-2450
Louvers & vents - penthouse
Not Started
0 %
08/31/2026
09/07/2026
+12d
Roofing & Dry-In 4
ENV-2300
Roofing membrane & insulation
Not Started
0 %
08/17/2026
09/04/2026
+12d
ENV-2320
Roof curbs & equipment pads
Not Started
0 %
08/10/2026
08/17/2026
+6d
ENV-2350
Building dry-in
Not Started
09/11/2026
09/11/2026
0d
ENV-2380
Exterior sealants - phase 1
Not Started
0 %
09/07/2026
09/18/2026
+5d
PROCUREMENT 4
Major Equipment 4
PRO-3100
Switchgear delivered1
Not Started
07/20/2026
07/20/2026
+5d
PRO-3200
Air-handling units delivered
Not Started
08/24/2026
08/24/2026
+10d
PRO-3250
Chiller delivered
Not Started
08/17/2026
08/17/2026
+4d
PRO-3300
Elevator equipment delivered
Not Started
09/14/2026
09/14/2026
+15d
MEP 11
Overhead Rough-In 6
MEP-4100
Corridor rack layout - L2
In Progress
25 %
06/29/2026
07/10/2026
+3d
MEP-4120
BIM coordination - corridor rack L3
Not Started
0 %
08/12/2026
08/25/2026
-2d
MEP-4150
Duct mains rough-in - L2
Not Started
0 %
07/13/2026
08/07/2026
+4d
MEP-4180
BIM clash resolution - OR suites
Not Started
0 %
08/26/2026
09/01/2026
-2d
MEP-4200
Sprinkler mains - L2-L3
Not Started
0 %
07/20/2026
08/14/2026
+7d
MEP-4250
Cable tray - imaging wing
Not Started
0 %
08/03/2026
08/21/2026
+9d
Systems & Mains 5
MEP-5020
Riser piping - core A
Not Started
0 %
07/27/2026
08/21/2026
+3d
MEP-5060
BIM coordination - mechanical mains
Not Started
0 %
09/02/2026
09/09/2026
-2d
MEP-5100
AHU setting & connections
Not Started
0 %
08/31/2026
09/18/2026
+6d
MEP-5150
Electrical rooms - gear setting
Not Started
0 %
08/24/2026
09/11/2026
+2d
MEP-5200
Hydro test - mains
Not Started
0 %
09/14/2026
09/21/2026
+8d
SAVED VIEWS
Full schedule
David's Saved BIM View
Critical path only
4-week lookahead
Save current view…
Edit columns…
Pretask.AI
Schedule Intelligence
Riverside Medical CenterRev 3 vs Rev 2 · Rev 0
Comments 3
Save Changes
Share
Export
Search activities…
Filters
Data Date 07/06/2026
Show all changes
View Setup
ID
ACTIVITY
STATUS
% COMPLETE
START
FINISH
FLOAT
Jun
Jul 2026
Aug 2026
Sep 2026
6/29
7/6
7/13
7/20
7/27
8/3
8/10
8/17
8/24
8/31
9/7
9/14
9/21
STEEL ERECTION 5
STR-1280
Steel erection — L2 north
In Progress
35 %
06/29/2026
07/17/2026
+2d
STR-1290
Bolt-up & plumb — L2Δ
Not Started
0 %
07/27/2026
08/07/2026
+1d
STR-1300
Steel & deck inspectionLOGIC Δ
Not Started
0 %
08/10/2026
08/14/2026
0d
STR-1320
Steel detail & touch-up — L2
Not Started
0 %
08/14/2026
08/21/2026
+6d
STR-1400
Steel topping-outMSΔ
Not Started
08/24/2026
0d
DECKS & CONCRETE 5
STR-1330
Metal deck — L3
Not Started
0 %
07/20/2026
08/03/2026
0d
STR-1340
Deck edge embeds & layout
Not Started
0 %
07/02/2026
07/16/2026
+4d
STR-1350
Concrete pour — L3 deck
Not Started
0 %
08/06/2026
08/12/2026
0d
STR-1360
Cure & saw-cut — L3
Not Started
0 %
08/12/2026
08/19/2026
+3d
STR-1370
Deck inspection — L3
Not Started
0 %
08/21/2026
08/25/2026
0d
CURTAIN WALL 4
GLZ-2100
Embeds & anchors — L2
Not Started
0 %
08/17/2026
08/28/2026
+5d
GLZ-2115
Curtain wall panels — L3 westΔ
Not Started
0 %
08/28/2026
09/11/2026
0d
GLZ-2130
Glazing — L3
Not Started
0 %
09/11/2026
09/23/2026
+2d
GLZ-2150
Perimeter sealants — L3
Not Started
0 %
09/17/2026
09/25/2026
+8d
ROOFING & DRY-IN 6
Activity Changes
STR-1300
Steel & deck inspection
CPLOGIC Δ
Rev 3 (primary) vs Rev 2 · Rev 0
REV 3REV 2REV 0Start08/10/2608/03/2607/28/26Finish08/14/2608/07/2608/03/26Float0d+4d+9d% Complete0 %0 %0 %
Highlighted values differ from the primary schedule.
Pretask.AI
Schedule Intelligence
Riverside Medical CenterRev 3
Comments 3
Save Changes
Share
Export
Search activities…
Filters
Data Date 07/06/2026
View Setup
ID
ACTIVITY
STATUS
% COMPLETE
START
FINISH
FLOAT
Jun
Jul 2026
Aug 2026
Sep 2026
6/29
7/6
7/13
7/20
7/27
8/3
8/10
8/17
8/24
8/31
9/7
9/14
9/21
STRUCTURE 13
Steel Erection 8
STR-1120
Erect structural steel - L1-L3
Complete
100 %
06/08/2026
06/26/2026
+8d
STR-1200
Erect structural steel - L4-L6
In Progress
70 %
06/15/2026
07/10/2026
0d
STR-1180
BIM coordination - steel connections
In Progress
30 %
07/01/2026
07/16/2026
-2d
STR-1230
Metal deck & shear studs - L5-L62
In Progress
35 %
06/29/2026
07/17/2026
-2d
STR-1240
Moment frame welds - L4-L6
In Progress
55 %
06/22/2026
07/14/2026
+2d
STR-1250
Stair steel - core B
Not Started
0 %
07/13/2026
07/24/2026
+6d
STR-1270
Plumb & align verification
Not Started
0 %
07/20/2026
07/27/2026
+1d
STR-1290
Steel topping-out milestone
Not Started
07/28/2026
07/28/2026
0d
Decks & Concrete 5
STR-1310
Place concrete on deck - L4
Not Started
0 %
07/15/2026
07/24/2026
+1d
STR-1320
Place concrete on deck - L5-L6
Not Started
0 %
07/24/2026
08/07/2026
0d
STR-1265
BIM clash check - deck penetrations
Not Started
0 %
07/17/2026
07/23/2026
-2d
STR-1340
Deck edge embeds & layout
Not Started
0 %
07/02/2026
07/16/2026
+4d
STR-1360
Cure & saw-cut joints
Not Started
0 %
08/07/2026
08/14/2026
+8d
ENVELOPE 12
Curtain Wall 8
ENV-2050
Curtain-wall shop drawings
In Progress
80 %
06/15/2026
07/08/2026
0d
ENV-2080
BIM model - curtain wall panels
Not Started
0 %
07/24/2026
08/06/2026
-2d
ENV-2090
BIM sign-off - NW Glazing Co.
Not Started
0 %
08/07/2026
08/11/2026
-2d
ENV-2110
Unitized panel fabrication1
Not Started
0 %
07/13/2026
08/21/2026
+2d
ENV-2150
Install curtain wall - North face
Not Started
0 %
07/27/2026
08/28/2026
0d
ENV-2200
Install curtain wall - South face
Not Started
0 %
08/10/2026
09/11/2026
+2d
ENV-2400
Storefront glazing - Main entry
Not Started
0 %
08/24/2026
09/11/2026
+9d
ENV-2450
Louvers & vents - penthouse
Not Started
0 %
08/31/2026
09/07/2026
+12d
Roofing & Dry-In 4
ENV-2300
Roofing membrane & insulation
Not Started
0 %
08/17/2026
09/04/2026
+12d
ENV-2320
Roof curbs & equipment pads
Not Started
0 %
08/10/2026
08/17/2026
+6d
ENV-2350
Building dry-in
Not Started
09/11/2026
09/11/2026
0d
ENV-2380
Exterior sealants - phase 1
Not Started
0 %
09/07/2026
09/18/2026
+5d
PROCUREMENT 4
Major Equipment 4
PRO-3100
Switchgear delivered1
Not Started
07/20/2026
07/20/2026
+5d
PRO-3200
Air-handling units delivered
Not Started
08/24/2026
08/24/2026
+10d
PRO-3250
Chiller delivered
Not Started
08/17/2026
08/17/2026
+4d
PRO-3300
Elevator equipment delivered
Not Started
09/14/2026
09/14/2026
+15d
MEP 11
Overhead Rough-In 6
MEP-4100
Corridor rack layout - L2
In Progress
25 %
06/29/2026
07/10/2026
+3d
MEP-4120
BIM coordination - corridor rack L3
Not Started
0 %
08/12/2026
08/25/2026
-2d
MEP-4150
Duct mains rough-in - L2
Not Started
0 %
07/13/2026
08/07/2026
+4d
MEP-4180
BIM clash resolution - OR suites
Not Started
0 %
08/26/2026
09/01/2026
-2d
MEP-4200
Sprinkler mains - L2-L3
Not Started
0 %
07/20/2026
08/14/2026
+7d
MEP-4250
Cable tray - imaging wing
Not Started
0 %
08/03/2026
08/21/2026
+9d
Systems & Mains 5
MEP-5020
Riser piping - core A
Not Started
0 %
07/27/2026
08/21/2026
+3d
MEP-5060
BIM coordination - mechanical mains
Not Started
0 %
09/02/2026
09/09/2026
-2d
MEP-5100
AHU setting & connections
Not Started
0 %
08/31/2026
09/18/2026
+6d
MEP-5150
Electrical rooms - gear setting
Not Started
0 %
08/24/2026
09/11/2026
+2d
MEP-5200
Hydro test - mains
Not Started
0 %
09/14/2026
09/21/2026
+8d

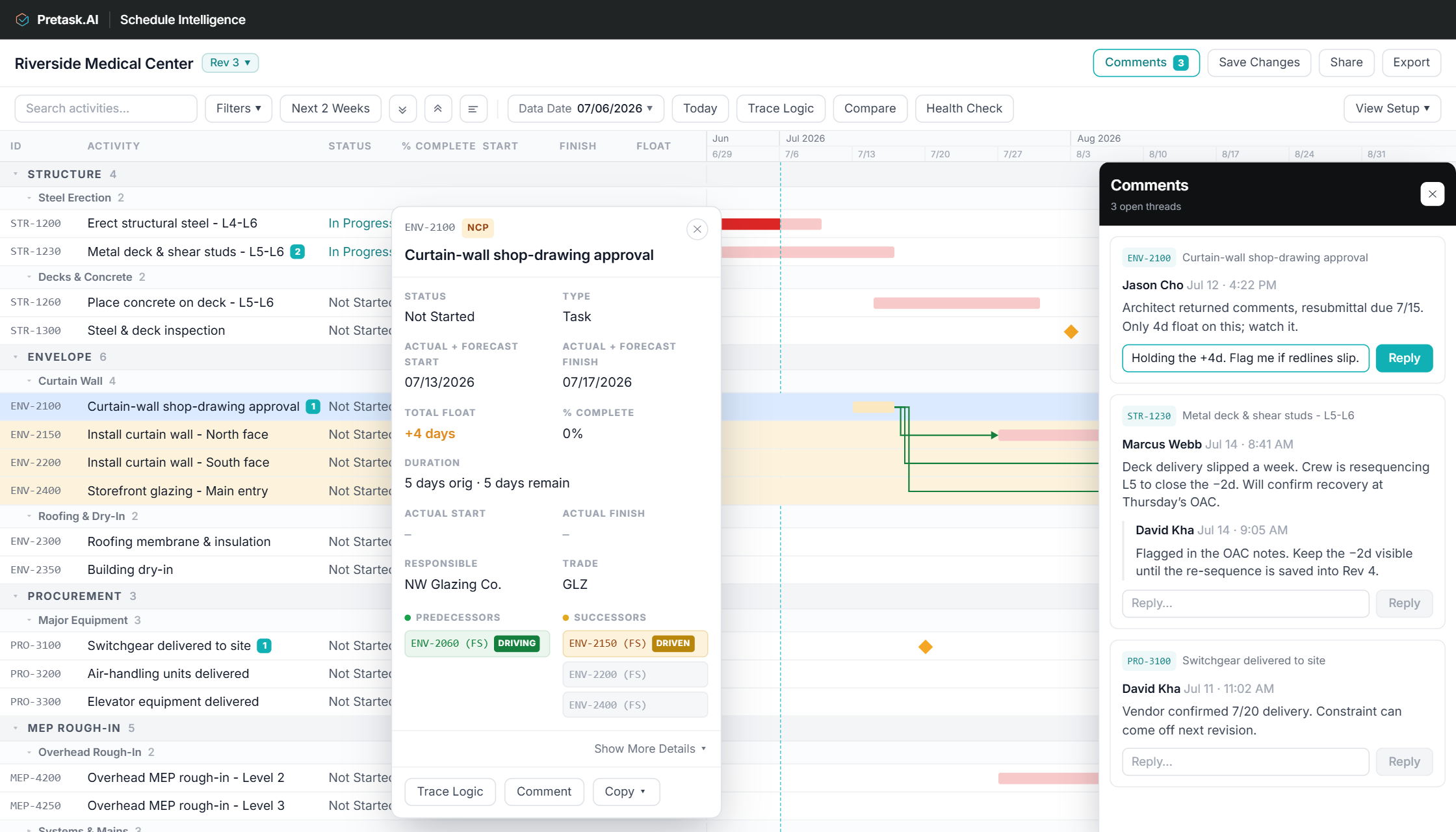

Pretask.AI
Schedule Intelligence
Riverside Medical CenterRev 3
Comments 3
Save Changes
Share
Export
Search activities…
Filters
Next 2 Weeks
Data Date 07/06/2026
Today
Trace Logic
Compare
Health Check
5,412 activities
View Setup
ID
ACTIVITY
STATUS
% COMPLETE
START
FINISH
FLOAT
Jun
Jul 2026
Aug 2026
Sep 2026
6/29
7/6
7/13
7/20
7/27
8/3
8/10
8/17
8/24
8/31
9/7
9/14
9/21
STRUCTURE 13
Steel Erection 8
STR-1120
Erect structural steel - L1-L3
Complete
100 %
06/08/2026
06/26/2026
+8d
STR-1200
Erect structural steel - L4-L6
In Progress
70 %
06/15/2026
07/10/2026
0d
STR-1180
BIM coordination - steel connections
In Progress
30 %
07/01/2026
07/16/2026
-2d
STR-1230
Metal deck & shear studs - L5-L62
In Progress
35 %
06/29/2026
07/17/2026
-2d
STR-1240
Moment frame welds - L4-L6
In Progress
55 %
06/22/2026
07/14/2026
+2d
STR-1250
Stair steel - core B
Not Started
0 %
07/13/2026
07/24/2026
+6d
STR-1270
Plumb & align verification
Not Started
0 %
07/20/2026
07/27/2026
+1d
STR-1290
Steel topping-out milestone
Not Started
07/28/2026
07/28/2026
0d
Decks & Concrete 5
STR-1310
Place concrete on deck - L4
Not Started
0 %
07/15/2026
07/24/2026
+1d
STR-1320
Place concrete on deck - L5-L6
Not Started
0 %
07/24/2026
08/07/2026
0d
STR-1265
BIM clash check - deck penetrations
Not Started
0 %
07/17/2026
07/23/2026
-2d
STR-1340
Deck edge embeds & layout
Not Started
0 %
07/02/2026
07/16/2026
+4d
STR-1360
Cure & saw-cut joints
Not Started
0 %
08/07/2026
08/14/2026
+8d
ENVELOPE 12
Curtain Wall 8
ENV-2050
Curtain-wall shop drawings
In Progress
80 %
06/15/2026
07/08/2026
0d
ENV-2080
BIM model - curtain wall panels
Not Started
0 %
07/24/2026
08/06/2026
-2d
ENV-2090
BIM sign-off - NW Glazing Co.
Not Started
0 %
08/07/2026
08/11/2026
-2d
ENV-2110
Unitized panel fabrication1
Not Started
0 %
07/13/2026
08/21/2026
+2d
ENV-2150
Install curtain wall - North face
Not Started
0 %
07/27/2026
08/28/2026
0d
ENV-2200
Install curtain wall - South face
Not Started
0 %
08/10/2026
09/11/2026
+2d
ENV-2400
Storefront glazing - Main entry
Not Started
0 %
08/24/2026
09/11/2026
+9d
ENV-2450
Louvers & vents - penthouse
Not Started
0 %
08/31/2026
09/07/2026
+12d
Roofing & Dry-In 4
ENV-2300
Roofing membrane & insulation
Not Started
0 %
08/17/2026
09/04/2026
+12d
ENV-2320
Roof curbs & equipment pads
Not Started
0 %
08/10/2026
08/17/2026
+6d
ENV-2350
Building dry-in
Not Started
09/11/2026
09/11/2026
0d
ENV-2380
Exterior sealants - phase 1
Not Started
0 %
09/07/2026
09/18/2026
+5d
PROCUREMENT 4
Major Equipment 4
PRO-3100
Switchgear delivered1
Not Started
07/20/2026
07/20/2026
+5d
PRO-3200
Air-handling units delivered
Not Started
08/24/2026
08/24/2026
+10d
PRO-3250
Chiller delivered
Not Started
08/17/2026
08/17/2026
+4d
PRO-3300
Elevator equipment delivered
Not Started
09/14/2026
09/14/2026
+15d
MEP 11
Overhead Rough-In 6
MEP-4100
Corridor rack layout - L2
In Progress
25 %
06/29/2026
07/10/2026
+3d
MEP-4120
BIM coordination - corridor rack L3
Not Started
0 %
08/12/2026
08/25/2026
-2d
MEP-4150
Duct mains rough-in - L2
Not Started
0 %
07/13/2026
08/07/2026
+4d
MEP-4180
BIM clash resolution - OR suites
Not Started
0 %
08/26/2026
09/01/2026
-2d
MEP-4200
Sprinkler mains - L2-L3
Not Started
0 %
07/20/2026
08/14/2026
+7d
MEP-4250
Cable tray - imaging wing
Not Started
0 %
08/03/2026
08/21/2026
+9d
Systems & Mains 5
MEP-5020
Riser piping - core A
Not Started
0 %
07/27/2026
08/21/2026
+3d
MEP-5060
BIM coordination - mechanical mains
Not Started
0 %
09/02/2026
09/09/2026
-2d
MEP-5100
AHU setting & connections
Not Started
0 %
08/31/2026
09/18/2026
+6d
MEP-5150
Electrical rooms - gear setting
Not Started
0 %
08/24/2026
09/11/2026
+2d
MEP-5200
Hydro test - mains
Not Started
0 %
09/14/2026
09/21/2026
+8d
Health Check & DCMA
Rev 3 · checked just now
DCMA SCORE
9.8/14
PASS9 checks
WARN1 check
FAIL2 checks
Weighted compliance: Pass earns full credit, Warning earns partial credit, Fail earns none. Not-applicable checks are excluded from the denominator.
#
CHECK
RESULT
STATUS
1
Logic
Activities missing predecessors or successors, excluding start and end milestones
0.0% (0 of 2,981 incomplete activities)
PASS
2
Leads
Negative lag values that can hide delays and compress logic artificially
0 lead relationships
PASS
3
Lags
Activities with lag values, especially excessive lags that mask intermediate work
0.8% (41 of 4,905 relationships)
STR-2140STR-2170· SS+20d
BIM-CO-1260BIM-CO-1270· SS+15d
BIM-CO-1030BIM-CO-1060· SS+10d
BIM-CO-1060BIM-CO-1090· SS+10d
BIM-CO-1090BIM-CO-1120· SS+10d
PASS
4
Relationship Types
Use of finish-to-start as the primary relationship type
83.4% FS (4,089 of 4,905 relationships)
1.5% SS (72 of 4,905 relationships)
15.1% FF (740 of 4,905 relationships)
0.1% SF (4 of 4,905 relationships)
WARN
5
Hard Constraints
MSO, MFO, and other hard constraints that override schedule logic
0.0% (1 of 2,981 incomplete activities)
PRO-3100 — SWITCHGEAR DELIVERED TO SITE · must finish on
PASS
6
High Float
Activities with total float above 44 days, indicating disconnected logic
59.1% (1,762 of 2,981 incomplete activities)
CXN-5010 — COMMISSIONING COMPLETE · 276d TFPWR-4820 — PERMANENT POWER ENERGIZED · 256d TFELV-4310 — ELEVATOR FINAL INSPECTION · 211d TFMED-4650 — MEDICAL EQUIPMENT INSTALL COMPLETE · 211d TFTCO-5250 — TCO INSPECTION · 198d TF
View all 1,762 issues
FAIL
7
Negative Float
Activities with total float below 0 days
0.0% (0 of 2,981 incomplete activities)
PASS
8
High Duration
Incomplete activities with remaining duration above 44 days
2.9% (86 of 2,981 incomplete activities)
PASS
9
Invalid Dates
Actual dates after the data date or forecast dates before it
0.0% (0 of 2,981 incomplete activities)
PASS
10
Resources
Activities with durations should carry resource or cost loading
Not resource or cost loaded
N/A
11
Missed Activities
Completed activities that finished after their baseline finish date
4.1% (99 of 2,431 completed activities)
PASS
12
Critical Path Test
Delaying a critical activity should move the project finish date
Finish did not respond to the test delay
FAIL
13
CPLI
Critical path length plus total float relative to path length
No must-finish constraint set
N/A
14
BEI
Activities completed versus activities planned to complete
1.01 (2,431 of 2,412 planned)
PASS
Pretask.AI
Schedule Intelligence
Riverside Medical CenterRev 3
Comments 3
Save Changes
Share
Export
Search activities…
Filters
Next 2 Weeks
Data Date 07/06/2026
Today
Trace Logic
Compare
Health Check

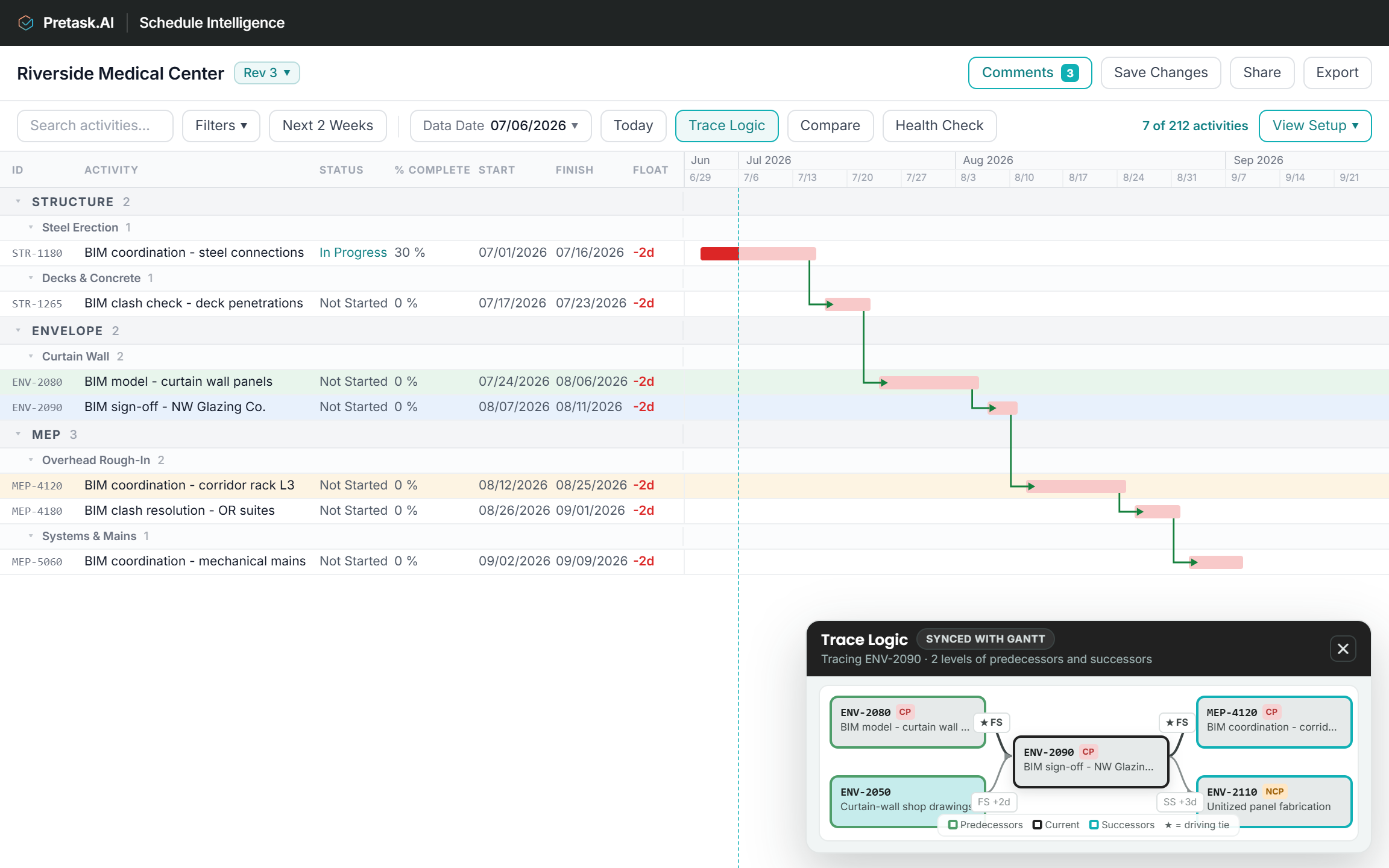

212 activities
View Setup
ID
ACTIVITY
STATUS
% COMPLETE
START
FINISH
FLOAT
Jun
Jul 2026
Aug 2026
Sep 2026
6/29
7/6
7/13
7/20
7/27
8/3
8/10
8/17
8/24
8/31
9/7
9/14
9/21
STRUCTURE 13
Steel Erection 8
STR-1120
Erect structural steel - L1-L3
Complete
100 %
06/08/2026
06/26/2026
+8d
STR-1200
Erect structural steel - L4-L6
In Progress
70 %
06/15/2026
07/10/2026
0d
STR-1180
BIM coordination - steel connections
In Progress
30 %
07/01/2026
07/16/2026
-2d
STR-1230
Metal deck & shear studs - L5-L62
In Progress
35 %
06/29/2026
07/17/2026
-2d
STR-1240
Moment frame welds - L4-L6
In Progress
55 %
06/22/2026
07/14/2026
+2d
STR-1250
Stair steel - core B
Not Started
0 %
07/13/2026
07/24/2026
+6d
STR-1270
Plumb & align verification
Not Started
0 %
07/20/2026
07/27/2026
+1d
STR-1290
Steel topping-out milestone
Not Started
07/28/2026
07/28/2026
0d
Decks & Concrete 5
STR-1310
Place concrete on deck - L4
Not Started
0 %
07/15/2026
07/24/2026
+1d
STR-1320
Place concrete on deck - L5-L6
Not Started
0 %
07/24/2026
08/07/2026
0d
STR-1265
BIM clash check - deck penetrations
Not Started
0 %
07/17/2026
07/23/2026
-2d
STR-1340
Deck edge embeds & layout
Not Started
0 %
07/02/2026
07/16/2026
+4d
STR-1360
Cure & saw-cut joints
Not Started
0 %
08/07/2026
08/14/2026
+8d
ENVELOPE 12
Curtain Wall 8
ENV-2050
Curtain-wall shop drawings
In Progress
80 %
06/15/2026
07/08/2026
0d
ENV-2080
BIM model - curtain wall panels
Not Started
0 %
07/24/2026
08/06/2026
-2d
ENV-2090
BIM sign-off - NW Glazing Co.
Not Started
0 %
08/07/2026
08/11/2026
-2d
ENV-2110
Unitized panel fabrication1
Not Started
0 %
07/13/2026
08/21/2026
+2d
ENV-2150
Install curtain wall - North face
Not Started
0 %
07/27/2026
08/28/2026
0d
ENV-2200
Install curtain wall - South face
Not Started
0 %
08/10/2026
09/11/2026
+2d
ENV-2400
Storefront glazing - Main entry
Not Started
0 %
08/24/2026
09/11/2026
+9d
ENV-2450
Louvers & vents - penthouse
Not Started
0 %
08/31/2026
09/07/2026
+12d
Roofing & Dry-In 4
ENV-2300
Roofing membrane & insulation
Not Started
0 %
08/17/2026
09/04/2026
+12d
ENV-2320
Roof curbs & equipment pads
Not Started
0 %
08/10/2026
08/17/2026
+6d
ENV-2350
Building dry-in
Not Started
09/11/2026
09/11/2026
0d
ENV-2380
Exterior sealants - phase 1
Not Started
0 %
09/07/2026
09/18/2026
+5d
PROCUREMENT 4
Major Equipment 4
PRO-3100
Switchgear delivered1
Not Started
07/20/2026
07/20/2026
+5d
PRO-3200
Air-handling units delivered
Not Started
08/24/2026
08/24/2026
+10d
PRO-3250
Chiller delivered
Not Started
08/17/2026
08/17/2026
+4d
PRO-3300
Elevator equipment delivered
Not Started
09/14/2026
09/14/2026
+15d
MEP 11
Overhead Rough-In 6
MEP-4100
Corridor rack layout - L2
In Progress
25 %
06/29/2026
07/10/2026
+3d
MEP-4120
BIM coordination - corridor rack L3
Not Started
0 %
08/12/2026
08/25/2026
-2d
MEP-4150
Duct mains rough-in - L2
Not Started
0 %
07/13/2026
08/07/2026
+4d
MEP-4180
BIM clash resolution - OR suites
Not Started
0 %
08/26/2026
09/01/2026
-2d
MEP-4200
Sprinkler mains - L2-L3
Not Started
0 %
07/20/2026
08/14/2026
+7d
MEP-4250
Cable tray - imaging wing
Not Started
0 %
08/03/2026
08/21/2026
+9d
Systems & Mains 5
MEP-5020
Riser piping - core A
Not Started
0 %
07/27/2026
08/21/2026
+3d
MEP-5060
BIM coordination - mechanical mains
Not Started
0 %
09/02/2026
09/09/2026
-2d
MEP-5100
AHU setting & connections
Not Started
0 %
08/31/2026
09/18/2026
+6d
MEP-5150
Electrical rooms - gear setting
Not Started
0 %
08/24/2026
09/11/2026
+2d
MEP-5200
Hydro test - mains
Not Started
0 %
09/14/2026
09/21/2026
+8d
STR-1340
Deck edge embeds & layout
Not Started
0 %
07/02/2026
07/16/2026
+4d
EXPORT
Export XER
Export PDF
Not Started
In Progress
Complete
July 2026
SMTWTFS
1234
567891011
12131415161718
19202122232425
262728293031
Schedule Viewing

Get answers faster

Pretask.AI
Schedule Intelligence
Riverside Medical CenterRev 3
Comments 3
Save Changes
Share
Export
Search activities…
Filters
Next 2 Weeks
Data Date 07/06/2026
Today
Trace Logic
Compare
Health Check
212 activities
View Setup
ID
ACTIVITY
STATUS
% COMPLETE
START
FINISH
FLOAT
Jun
Jul 2026
Aug 2026
Sep 2026
6/29
7/6
7/13
7/20
7/27
8/3
8/10
8/17
8/24
8/31
9/7
9/14
9/21
STRUCTURE 13
Steel Erection 8
STR-1120
Erect structural steel - L1-L3
Complete
100 %
06/08/2026
06/26/2026
+8d
STR-1200
Erect structural steel - L4-L6
In Progress
70 %
06/15/2026
07/10/2026
0d
STR-1180
BIM coordination - steel connections
In Progress
30 %
07/01/2026
07/16/2026
-2d
STR-1230
Metal deck & shear studs - L5-L62
In Progress
35 %
06/29/2026
07/17/2026
-2d
STR-1240
Moment frame welds - L4-L6
In Progress
55 %
06/22/2026
07/14/2026
+2d
STR-1250
Stair steel - core B
Not Started
0 %
07/13/2026
07/24/2026
+6d
STR-1270
Plumb & align verification
Not Started
0 %
07/20/2026
07/27/2026
+1d
STR-1290
Steel topping-out milestone
Not Started
07/28/2026
07/28/2026
0d
Decks & Concrete 5
STR-1310
Place concrete on deck - L4
Not Started
0 %
07/15/2026
07/24/2026
+1d
STR-1320
Place concrete on deck - L5-L6
Not Started
0 %
07/24/2026
08/07/2026
0d
STR-1265
BIM clash check - deck penetrations
Not Started
0 %
07/17/2026
07/23/2026
-2d
STR-1340
Deck edge embeds & layout
Not Started
0 %
07/02/2026
07/16/2026
+4d
STR-1360
Cure & saw-cut joints
Not Started
0 %
08/07/2026
08/14/2026
+8d
ENVELOPE 12
Curtain Wall 8
ENV-2050
Curtain-wall shop drawings
In Progress
80 %
06/15/2026
07/08/2026
0d
ENV-2080
BIM model - curtain wall panels
Not Started
0 %
07/24/2026
08/06/2026
-2d
ENV-2090
BIM sign-off - NW Glazing Co.
Not Started
0 %
08/07/2026
08/11/2026
-2d
ENV-2110
Unitized panel fabrication1
Not Started
0 %
07/13/2026
08/21/2026
+2d
ENV-2150
Install curtain wall - North face
Not Started
0 %
07/27/2026
08/28/2026
0d
ENV-2200
Install curtain wall - South face
Not Started
0 %
08/10/2026
09/11/2026
+2d
ENV-2400
Storefront glazing - Main entry
Not Started
0 %
08/24/2026
09/11/2026
+9d
ENV-2450
Louvers & vents - penthouse
Not Started
0 %
08/31/2026
09/07/2026
+12d
Roofing & Dry-In 4
ENV-2300
Roofing membrane & insulation
Not Started
0 %
08/17/2026
09/04/2026
+12d
ENV-2320
Roof curbs & equipment pads
Not Started
0 %
08/10/2026
08/17/2026
+6d
ENV-2350
Building dry-in
Not Started
09/11/2026
09/11/2026
0d
ENV-2380
Exterior sealants - phase 1
Not Started
0 %
09/07/2026
09/18/2026
+5d
PROCUREMENT 4
Major Equipment 4
PRO-3100
Switchgear delivered1
Not Started
07/20/2026
07/20/2026
+5d
PRO-3200
Air-handling units delivered
Not Started
08/24/2026
08/24/2026
+10d
PRO-3250
Chiller delivered
Not Started
08/17/2026
08/17/2026
+4d
PRO-3300
Elevator equipment delivered
Not Started
09/14/2026
09/14/2026
+15d
MEP 11
Overhead Rough-In 6
MEP-4100
Corridor rack layout - L2
In Progress
25 %
06/29/2026
07/10/2026
+3d
MEP-4120
BIM coordination - corridor rack L3
Not Started
0 %
08/12/2026
08/25/2026
-2d
MEP-4150
Duct mains rough-in - L2
Not Started
0 %
07/13/2026
08/07/2026
+4d
MEP-4180
BIM clash resolution - OR suites
Not Started
0 %
08/26/2026
09/01/2026
-2d
MEP-4200
Sprinkler mains - L2-L3
Not Started
0 %
07/20/2026
08/14/2026
+7d
MEP-4250
Cable tray - imaging wing
Not Started
0 %
08/03/2026
08/21/2026
+9d
Systems & Mains 5
MEP-5020
Riser piping - core A
Not Started
0 %
07/27/2026
08/21/2026
+3d
MEP-5060
BIM coordination - mechanical mains
Not Started
0 %
09/02/2026
09/09/2026
-2d
MEP-5100
AHU setting & connections
Not Started
0 %
08/31/2026
09/18/2026
+6d
MEP-5150
Electrical rooms - gear setting
Not Started
0 %
08/24/2026
09/11/2026
+2d
MEP-5200
Hydro test - mains
Not Started
0 %
09/14/2026
09/21/2026
+8d
SAVED VIEWS
Full schedule
David's Saved BIM View
Critical path only
4-week lookahead
Save current view…
Edit columns…
See what you need, follow the logic
Configurable saved views
Search
Group by WBS
Add and remove columns
Show critical path
Filter and sort
Filter by activity code
Trace logicLogic arrows
Revision Comparison

Compare revisions to understand what changed

Compare up to four revisions in the same screen.  Immediately see changes in dates, progress, activities, and logic.

Pretask.AI
Schedule Intelligence
Riverside Medical CenterRev 3 vs Rev 2 · Rev 0
Comments 3
Save Changes
Share
Export
Search activities…
Filters
Data Date 07/06/2026
Show all changes
View Setup
ID
ACTIVITY
STATUS
% COMPLETE
START
FINISH
FLOAT
Jun
Jul 2026
Aug 2026
Sep 2026
6/29
7/6
7/13
7/20
7/27
8/3
8/10
8/17
8/24
8/31
9/7
9/14
9/21
STEEL ERECTION 5
STR-1280
Steel erection — L2 north
In Progress
35 %
06/29/2026
07/17/2026
+2d
STR-1290
Bolt-up & plumb — L2Δ
Not Started
0 %
07/27/2026
08/07/2026
+1d
STR-1300
Steel & deck inspectionLOGIC Δ
Not Started
0 %
08/10/2026
08/14/2026
0d
STR-1320
Steel detail & touch-up — L2
Not Started
0 %
08/14/2026
08/21/2026
+6d
STR-1400
Steel topping-outMSΔ
Not Started
08/24/2026
0d
DECKS & CONCRETE 5
STR-1330
Metal deck — L3
Not Started
0 %
07/20/2026
08/03/2026
0d
STR-1340
Deck edge embeds & layout
Not Started
0 %
07/02/2026
07/16/2026
+4d
STR-1350
Concrete pour — L3 deck
Not Started
0 %
08/06/2026
08/12/2026
0d
STR-1360
Cure & saw-cut — L3
Not Started
0 %
08/12/2026
08/19/2026
+3d
STR-1370
Deck inspection — L3
Not Started
0 %
08/21/2026
08/25/2026
0d
CURTAIN WALL 4
GLZ-2100
Embeds & anchors — L2
Not Started
0 %
08/17/2026
08/28/2026
+5d
GLZ-2115
Curtain wall panels — L3 westΔ
Not Started
0 %
08/28/2026
09/11/2026
0d
GLZ-2130
Glazing — L3
Not Started
0 %
09/11/2026
09/23/2026
+2d
GLZ-2150
Perimeter sealants — L3
Not Started
0 %
09/17/2026
09/25/2026
+8d
ROOFING & DRY-IN 6
Activity Changes
STR-1300
Steel & deck inspection
CPLOGIC Δ
Rev 3 (primary) vs Rev 2 · Rev 0
REV 3REV 2REV 0Start08/10/2608/03/2607/28/26Finish08/14/2608/07/2608/03/26Float0d+4d+9d% Complete0 %0 %0 %
Highlighted values differ from the primary schedule.
See the changes side by side

Show all changes to see every difference instantly. Click a flagged activity to see its dates, progress, and logic against the primary revision.

See activities added and removed

New scope in, deleted scope out. Both surface in the comparison.

Date changesLogic changesAddedRemoved
Share and collaborate

Collaborate in one shared workspace

Pretask.AI
Schedule Intelligence
Riverside Medical CenterRev 3
Comments 3
Save Changes
Share
Export
Search activities…
Filters
Data Date 07/06/2026
View Setup
ID
ACTIVITY
STATUS
% COMPLETE
START
FINISH
FLOAT
Jun
Jul 2026
Aug 2026
Sep 2026
6/29
7/6
7/13
7/20
7/27
8/3
8/10
8/17
8/24
8/31
9/7
9/14
9/21
STRUCTURE 13
Steel Erection 8
STR-1120
Erect structural steel - L1-L3
Complete
100 %
06/08/2026
06/26/2026
+8d
STR-1200
Erect structural steel - L4-L6
In Progress
70 %
06/15/2026
07/10/2026
0d
STR-1180
BIM coordination - steel connections
In Progress
30 %
07/01/2026
07/16/2026
-2d
STR-1230
Metal deck & shear studs - L5-L62
In Progress
35 %
06/29/2026
07/17/2026
-2d
STR-1240
Moment frame welds - L4-L6
In Progress
55 %
06/22/2026
07/14/2026
+2d
STR-1250
Stair steel - core B
Not Started
0 %
07/13/2026
07/24/2026
+6d
STR-1270
Plumb & align verification
Not Started
0 %
07/20/2026
07/27/2026
+1d
STR-1290
Steel topping-out milestone
Not Started
07/28/2026
07/28/2026
0d
Decks & Concrete 5
STR-1310
Place concrete on deck - L4
Not Started
0 %
07/15/2026
07/24/2026
+1d
STR-1320
Place concrete on deck - L5-L6
Not Started
0 %
07/24/2026
08/07/2026
0d
STR-1265
BIM clash check - deck penetrations
Not Started
0 %
07/17/2026
07/23/2026
-2d
STR-1340
Deck edge embeds & layout
Not Started
0 %
07/02/2026
07/16/2026
+4d
STR-1360
Cure & saw-cut joints
Not Started
0 %
08/07/2026
08/14/2026
+8d
ENVELOPE 12
Curtain Wall 8
ENV-2050
Curtain-wall shop drawings
In Progress
80 %
06/15/2026
07/08/2026
0d
ENV-2080
BIM model - curtain wall panels
Not Started
0 %
07/24/2026
08/06/2026
-2d
ENV-2090
BIM sign-off - NW Glazing Co.
Not Started
0 %
08/07/2026
08/11/2026
-2d
ENV-2110
Unitized panel fabrication1
Not Started
0 %
07/13/2026
08/21/2026
+2d
ENV-2150
Install curtain wall - North face
Not Started
0 %
07/27/2026
08/28/2026
0d
ENV-2200
Install curtain wall - South face
Not Started
0 %
08/10/2026
09/11/2026
+2d
ENV-2400
Storefront glazing - Main entry
Not Started
0 %
08/24/2026
09/11/2026
+9d
ENV-2450
Louvers & vents - penthouse
Not Started
0 %
08/31/2026
09/07/2026
+12d
Roofing & Dry-In 4
ENV-2300
Roofing membrane & insulation
Not Started
0 %
08/17/2026
09/04/2026
+12d
ENV-2320
Roof curbs & equipment pads
Not Started
0 %
08/10/2026
08/17/2026
+6d
ENV-2350
Building dry-in
Not Started
09/11/2026
09/11/2026
0d
ENV-2380
Exterior sealants - phase 1
Not Started
0 %
09/07/2026
09/18/2026
+5d
PROCUREMENT 4
Major Equipment 4
PRO-3100
Switchgear delivered1
Not Started
07/20/2026
07/20/2026
+5d
PRO-3200
Air-handling units delivered
Not Started
08/24/2026
08/24/2026
+10d
PRO-3250
Chiller delivered
Not Started
08/17/2026
08/17/2026
+4d
PRO-3300
Elevator equipment delivered
Not Started
09/14/2026
09/14/2026
+15d
MEP 11
Overhead Rough-In 6
MEP-4100
Corridor rack layout - L2
In Progress
25 %
06/29/2026
07/10/2026
+3d
MEP-4120
BIM coordination - corridor rack L3
Not Started
0 %
08/12/2026
08/25/2026
-2d
MEP-4150
Duct mains rough-in - L2
Not Started
0 %
07/13/2026
08/07/2026
+4d
MEP-4180
BIM clash resolution - OR suites
Not Started
0 %
08/26/2026
09/01/2026
-2d
MEP-4200
Sprinkler mains - L2-L3
Not Started
0 %
07/20/2026
08/14/2026
+7d
MEP-4250
Cable tray - imaging wing
Not Started
0 %
08/03/2026
08/21/2026
+9d
Systems & Mains 5
MEP-5020
Riser piping - core A
Not Started
0 %
07/27/2026
08/21/2026
+3d
MEP-5060
BIM coordination - mechanical mains
Not Started
0 %
09/02/2026
09/09/2026
-2d
MEP-5100
AHU setting & connections
Not Started
0 %
08/31/2026
09/18/2026
+6d
MEP-5150
Electrical rooms - gear setting
Not Started
0 %
08/24/2026
09/11/2026
+2d
MEP-5200
Hydro test - mains
Not Started
0 %
09/14/2026
09/21/2026
+8d

Review and discuss the P6 schedule, without needing Oracle Primavera P6 licenses.

Everyone on the same revision

Invite project partners to the exact schedule revision under review so each person starts from the same information.

Communicate with context

Keep every thread attached to the activity or WBS row it concerns rather than losing the discussion across email, PDFs, and meeting notes.

Schedule health

One click to know if the project finishes on time

Get instant validation scoring, risk identification, and critical path analysis with underlying reasons. Jump directly to the affected activities for additional context.

14 point DCMA check

Is this schedule mechanically credible?

LogicLeadsLagsRelationship typesHard constraintsHigh floatNegative floatHigh durationInvalid datesResourcesMissed tasksCritical path testCPLIBEI
8 additional risk checks

How serious are the problems and what is dragging the score down?

Soft constraints: ALAP, SNET, FNLT and other non-mandatory constraints on incomplete work.
Long FS lags: Finish-to-start ties with excessive lag that can mask intermediate work.
Riding data date: Incomplete activities with start dates anchored at the status date.
Out-of-sequence progress: Actual progress inconsistent with finish-to-start logic order.
Near-critical exposure: Incomplete activities within the near-critical float band.
Merge hotspots: Activities with high fan-in logic concentration.
Finisher path clarity: Advisory diagnostics on the acceptance and finish path.
Progress date inconsistency: Reported status or actual dates that conflict with the planned finish.
Critical Activities

Which specific activities warrant review first?

Know what to chase before the finish date slips. Schedule Intelligence ranks the activities deciding it and shows why each made the list. Jump straight to them in the Gantt, or take the list to your next meeting.

PassWarningFail
Pretask.AI
Schedule Intelligence
Riverside Medical CenterRev 3
Comments 3
Save Changes
Share
Export
Search activities…
Filters
Next 2 Weeks
Data Date 07/06/2026
Today
Trace Logic
Compare
Health Check
5,412 activities
View Setup
ID
ACTIVITY
STATUS
% COMPLETE
START
FINISH
FLOAT
Jun
Jul 2026
Aug 2026
Sep 2026
6/29
7/6
7/13
7/20
7/27
8/3
8/10
8/17
8/24
8/31
9/7
9/14
9/21
STRUCTURE 13
Steel Erection 8
STR-1120
Erect structural steel - L1-L3
Complete
100 %
06/08/2026
06/26/2026
+8d
STR-1200
Erect structural steel - L4-L6
In Progress
70 %
06/15/2026
07/10/2026
0d
STR-1180
BIM coordination - steel connections
In Progress
30 %
07/01/2026
07/16/2026
-2d
STR-1230
Metal deck & shear studs - L5-L62
In Progress
35 %
06/29/2026
07/17/2026
-2d
STR-1240
Moment frame welds - L4-L6
In Progress
55 %
06/22/2026
07/14/2026
+2d
STR-1250
Stair steel - core B
Not Started
0 %
07/13/2026
07/24/2026
+6d
STR-1270
Plumb & align verification
Not Started
0 %
07/20/2026
07/27/2026
+1d
STR-1290
Steel topping-out milestone
Not Started
07/28/2026
07/28/2026
0d
Decks & Concrete 5
STR-1310
Place concrete on deck - L4
Not Started
0 %
07/15/2026
07/24/2026
+1d
STR-1320
Place concrete on deck - L5-L6
Not Started
0 %
07/24/2026
08/07/2026
0d
STR-1265
BIM clash check - deck penetrations
Not Started
0 %
07/17/2026
07/23/2026
-2d
STR-1340
Deck edge embeds & layout
Not Started
0 %
07/02/2026
07/16/2026
+4d
STR-1360
Cure & saw-cut joints
Not Started
0 %
08/07/2026
08/14/2026
+8d
ENVELOPE 12
Curtain Wall 8
ENV-2050
Curtain-wall shop drawings
In Progress
80 %
06/15/2026
07/08/2026
0d
ENV-2080
BIM model - curtain wall panels
Not Started
0 %
07/24/2026
08/06/2026
-2d
ENV-2090
BIM sign-off - NW Glazing Co.
Not Started
0 %
08/07/2026
08/11/2026
-2d
ENV-2110
Unitized panel fabrication1
Not Started
0 %
07/13/2026
08/21/2026
+2d
ENV-2150
Install curtain wall - North face
Not Started
0 %
07/27/2026
08/28/2026
0d
ENV-2200
Install curtain wall - South face
Not Started
0 %
08/10/2026
09/11/2026
+2d
ENV-2400
Storefront glazing - Main entry
Not Started
0 %
08/24/2026
09/11/2026
+9d
ENV-2450
Louvers & vents - penthouse
Not Started
0 %
08/31/2026
09/07/2026
+12d
Roofing & Dry-In 4
ENV-2300
Roofing membrane & insulation
Not Started
0 %
08/17/2026
09/04/2026
+12d
ENV-2320
Roof curbs & equipment pads
Not Started
0 %
08/10/2026
08/17/2026
+6d
ENV-2350
Building dry-in
Not Started
09/11/2026
09/11/2026
0d
ENV-2380
Exterior sealants - phase 1
Not Started
0 %
09/07/2026
09/18/2026
+5d
PROCUREMENT 4
Major Equipment 4
PRO-3100
Switchgear delivered1
Not Started
07/20/2026
07/20/2026
+5d
PRO-3200
Air-handling units delivered
Not Started
08/24/2026
08/24/2026
+10d
PRO-3250
Chiller delivered
Not Started
08/17/2026
08/17/2026
+4d
PRO-3300
Elevator equipment delivered
Not Started
09/14/2026
09/14/2026
+15d
MEP 11
Overhead Rough-In 6
MEP-4100
Corridor rack layout - L2
In Progress
25 %
06/29/2026
07/10/2026
+3d
MEP-4120
BIM coordination - corridor rack L3
Not Started
0 %
08/12/2026
08/25/2026
-2d
MEP-4150
Duct mains rough-in - L2
Not Started
0 %
07/13/2026
08/07/2026
+4d
MEP-4180
BIM clash resolution - OR suites
Not Started
0 %
08/26/2026
09/01/2026
-2d
MEP-4200
Sprinkler mains - L2-L3
Not Started
0 %
07/20/2026
08/14/2026
+7d
MEP-4250
Cable tray - imaging wing
Not Started
0 %
08/03/2026
08/21/2026
+9d
Systems & Mains 5
MEP-5020
Riser piping - core A
Not Started
0 %
07/27/2026
08/21/2026
+3d
MEP-5060
BIM coordination - mechanical mains
Not Started
0 %
09/02/2026
09/09/2026
-2d
MEP-5100
AHU setting & connections
Not Started
0 %
08/31/2026
09/18/2026
+6d
MEP-5150
Electrical rooms - gear setting
Not Started
0 %
08/24/2026
09/11/2026
+2d
MEP-5200
Hydro test - mains
Not Started
0 %
09/14/2026
09/21/2026
+8d
Health Check & DCMA
Rev 3 · checked just now
DCMA SCORE
9.8/14
PASS9 checks
WARN1 check
FAIL2 checks
Weighted compliance: Pass earns full credit, Warning earns partial credit, Fail earns none. Not-applicable checks are excluded from the denominator.
#
CHECK
RESULT
STATUS
1
Logic
Activities missing predecessors or successors, excluding start and end milestones
0.0% (0 of 2,981 incomplete activities)
PASS
2
Leads
Negative lag values that can hide delays and compress logic artificially
0 lead relationships
PASS
3
Lags
Activities with lag values, especially excessive lags that mask intermediate work
0.8% (41 of 4,905 relationships)
STR-2140STR-2170· SS+20d
BIM-CO-1260BIM-CO-1270· SS+15d
BIM-CO-1030BIM-CO-1060· SS+10d
BIM-CO-1060BIM-CO-1090· SS+10d
BIM-CO-1090BIM-CO-1120· SS+10d
PASS
4
Relationship Types
Use of finish-to-start as the primary relationship type
83.4% FS (4,089 of 4,905 relationships)
1.5% SS (72 of 4,905 relationships)
15.1% FF (740 of 4,905 relationships)
0.1% SF (4 of 4,905 relationships)
WARN
5
Hard Constraints
MSO, MFO, and other hard constraints that override schedule logic
0.0% (1 of 2,981 incomplete activities)
PRO-3100 — SWITCHGEAR DELIVERED TO SITE · must finish on
PASS
6
High Float
Activities with total float above 44 days, indicating disconnected logic
59.1% (1,762 of 2,981 incomplete activities)
CXN-5010 — COMMISSIONING COMPLETE · 276d TFPWR-4820 — PERMANENT POWER ENERGIZED · 256d TFELV-4310 — ELEVATOR FINAL INSPECTION · 211d TFMED-4650 — MEDICAL EQUIPMENT INSTALL COMPLETE · 211d TFTCO-5250 — TCO INSPECTION · 198d TF
View all 1,762 issues
FAIL
7
Negative Float
Activities with total float below 0 days
0.0% (0 of 2,981 incomplete activities)
PASS
8
High Duration
Incomplete activities with remaining duration above 44 days
2.9% (86 of 2,981 incomplete activities)
PASS
9
Invalid Dates
Actual dates after the data date or forecast dates before it
0.0% (0 of 2,981 incomplete activities)
PASS
10
Resources
Activities with durations should carry resource or cost loading
Not resource or cost loaded
N/A
11
Missed Activities
Completed activities that finished after their baseline finish date
4.1% (99 of 2,431 completed activities)
PASS
12
Critical Path Test
Delaying a critical activity should move the project finish date
Finish did not respond to the test delay
FAIL
13
CPLI
Critical path length plus total float relative to path length
No must-finish constraint set
N/A
14
BEI
Activities completed versus activities planned to complete
1.01 (2,431 of 2,412 planned)
PASS
Update & export

Turn project inputs into usable schedule updates

Record status, percent complete, actual dates, and activity level context in a working revision. Save it, share it, and export an updated XER or meeting-ready PDF.

Pretask.AI
Schedule Intelligence
Riverside Medical CenterRev 3
Comments 3
Save Changes
Share
Export
Search activities…
Filters
Next 2 Weeks
Data Date 07/06/2026
Today
Trace Logic
Compare
Health Check
212 activities
View Setup
ID
ACTIVITY
STATUS
% COMPLETE
START
FINISH
FLOAT
Jun
Jul 2026
Aug 2026
Sep 2026
6/29
7/6
7/13
7/20
7/27
8/3
8/10
8/17
8/24
8/31
9/7
9/14
9/21
STRUCTURE 13
Steel Erection 8
STR-1120
Erect structural steel - L1-L3
Complete
100 %
06/08/2026
06/26/2026
+8d
STR-1200
Erect structural steel - L4-L6
In Progress
70 %
06/15/2026
07/10/2026
0d
STR-1180
BIM coordination - steel connections
In Progress
30 %
07/01/2026
07/16/2026
-2d
STR-1230
Metal deck & shear studs - L5-L62
In Progress
35 %
06/29/2026
07/17/2026
-2d
STR-1240
Moment frame welds - L4-L6
In Progress
55 %
06/22/2026
07/14/2026
+2d
STR-1250
Stair steel - core B
Not Started
0 %
07/13/2026
07/24/2026
+6d
STR-1270
Plumb & align verification
Not Started
0 %
07/20/2026
07/27/2026
+1d
STR-1290
Steel topping-out milestone
Not Started
07/28/2026
07/28/2026
0d
Decks & Concrete 5
STR-1310
Place concrete on deck - L4
Not Started
0 %
07/15/2026
07/24/2026
+1d
STR-1320
Place concrete on deck - L5-L6
Not Started
0 %
07/24/2026
08/07/2026
0d
STR-1265
BIM clash check - deck penetrations
Not Started
0 %
07/17/2026
07/23/2026
-2d
STR-1340
Deck edge embeds & layout
Not Started
0 %
07/02/2026
07/16/2026
+4d
STR-1360
Cure & saw-cut joints
Not Started
0 %
08/07/2026
08/14/2026
+8d
ENVELOPE 12
Curtain Wall 8
ENV-2050
Curtain-wall shop drawings
In Progress
80 %
06/15/2026
07/08/2026
0d
ENV-2080
BIM model - curtain wall panels
Not Started
0 %
07/24/2026
08/06/2026
-2d
ENV-2090
BIM sign-off - NW Glazing Co.
Not Started
0 %
08/07/2026
08/11/2026
-2d
ENV-2110
Unitized panel fabrication1
Not Started
0 %
07/13/2026
08/21/2026
+2d
ENV-2150
Install curtain wall - North face
Not Started
0 %
07/27/2026
08/28/2026
0d
ENV-2200
Install curtain wall - South face
Not Started
0 %
08/10/2026
09/11/2026
+2d
ENV-2400
Storefront glazing - Main entry
Not Started
0 %
08/24/2026
09/11/2026
+9d
ENV-2450
Louvers & vents - penthouse
Not Started
0 %
08/31/2026
09/07/2026
+12d
Roofing & Dry-In 4
ENV-2300
Roofing membrane & insulation
Not Started
0 %
08/17/2026
09/04/2026
+12d
ENV-2320
Roof curbs & equipment pads
Not Started
0 %
08/10/2026
08/17/2026
+6d
ENV-2350
Building dry-in
Not Started
09/11/2026
09/11/2026
0d
ENV-2380
Exterior sealants - phase 1
Not Started
0 %
09/07/2026
09/18/2026
+5d
PROCUREMENT 4
Major Equipment 4
PRO-3100
Switchgear delivered1
Not Started
07/20/2026
07/20/2026
+5d
PRO-3200
Air-handling units delivered
Not Started
08/24/2026
08/24/2026
+10d
PRO-3250
Chiller delivered
Not Started
08/17/2026
08/17/2026
+4d
PRO-3300
Elevator equipment delivered
Not Started
09/14/2026
09/14/2026
+15d
MEP 11
Overhead Rough-In 6
MEP-4100
Corridor rack layout - L2
In Progress
25 %
06/29/2026
07/10/2026
+3d
MEP-4120
BIM coordination - corridor rack L3
Not Started
0 %
08/12/2026
08/25/2026
-2d
MEP-4150
Duct mains rough-in - L2
Not Started
0 %
07/13/2026
08/07/2026
+4d
MEP-4180
BIM clash resolution - OR suites
Not Started
0 %
08/26/2026
09/01/2026
-2d
MEP-4200
Sprinkler mains - L2-L3
Not Started
0 %
07/20/2026
08/14/2026
+7d
MEP-4250
Cable tray - imaging wing
Not Started
0 %
08/03/2026
08/21/2026
+9d
Systems & Mains 5
MEP-5020
Riser piping - core A
Not Started
0 %
07/27/2026
08/21/2026
+3d
MEP-5060
BIM coordination - mechanical mains
Not Started
0 %
09/02/2026
09/09/2026
-2d
MEP-5100
AHU setting & connections
Not Started
0 %
08/31/2026
09/18/2026
+6d
MEP-5150
Electrical rooms - gear setting
Not Started
0 %
08/24/2026
09/11/2026
+2d
MEP-5200
Hydro test - mains
Not Started
0 %
09/14/2026
09/21/2026
+8d
STR-1340
Deck edge embeds & layout
Not Started
0 %
07/02/2026
07/16/2026
+4d
EXPORT
Export XER
Export PDF
Not Started
In Progress
Complete
July 2026
SMTWTFS
1234
567891011
12131415161718
19202122232425
262728293031
1
Capture progress

Update status, percent complete, and actual dates against the relevant activities.

2
Save a working revision

Save updates to the existing file, or save as a new revision so the original stays untouched.

3
Export XER or PDF

Return an updated XER to P6 or create a clear PDF for the next meeting.

ABOUT US
United States flag

Top tier operators from construction, tech, and AI.  $20B+ in impact to the construction environment.

David Kha
David Kha
David Kha on LinkedIn
Cofounder, CEO

A decade in SaaS, most recently at Revizto helping some of the largest AEC firms in the US  improve project delivery.

Jason Cho, PhD
Jason Cho, PhD
Jason Cho on LinkedIn
Cofounder, CTO

Ex-Director of Machine Learning at Walmart building their prediction technology. 20+ patents, now leading Pretask.AI's technical direction on predictive intelligence for AEC.

Chris Morris
Chris Morris
Chris Morris on LinkedIn
Advisor

Ex-Swinerton National VP (retired). Chris is now supplementing our domain expertise with his extensive construction executive experience.

Read more

Building predictive intelligence for the AEC industry

Pricing

Let's help you work and collaborate better.  Priced accessibly for everyone.

Standard
$14per user / month, billed annually
Great for individuals who just need to view schedules
Schedule Viewing
Revision Comparison
Update and export
Pro
$18per user / month, billed annually
For teams who need a collaborative environment
Everything in Standard
Share and collaborate
Schedule Health
Comments
1 new thread
David Kha
David Kha just now
CEO, Pretask.AI

Still thinking about it? Try it for free.

30 day free trial
Up to 5 users
One project
Unlimited schedule revisions
All features of Pro included
No credit card, no commitment

Try it on a live project.

Free 30-day trial · up to 5 users · unlimited schedule revisions

Don't need the trial?Sign up for waitlist
FAQ

Sure! Email us at sales@pretask.ai and we’ll get back to you right away.

The export format Primavera P6 uses for schedules. If someone sent you “the schedule” as a file, it is probably an XER. Pretask opens it in your browser.  No software to install.

No. Schedule Intelligence acts as the accessible view and collaboration tool for the broader project team where P6 is either too expensive or too complex to be practical for everyone on the project. You simply upload the P6 file (XER) and the full schedule opens in your browser. No P6 license, and no dedicated software to install.

Not for the scheduler responsible for building and maintaining the master schedule. P6 remains the system of record for schedule logic, calendars, sequencing, and formal schedule updates.

For the rest of the project team, Schedule Intelligence can replace the need to work directly in P6. Schedule Intelligence lets you review the schedule, trace logic, comment on activities, run health checks, and update status, percent complete, and actual start/finish dates without needing your own P6 license. Schedule Intelligence can then export an updated XER for the scheduler to review and continue maintaining in P6.

We currently support Primavera P6 XER files. If you’d like us to consider other formats, drop us a line at sales@pretask.ai.

Yes. Edit status, percent complete, and actual start/finish dates. Save your work as a revision and export an updated XER or a multi-page PDF.

Only people you invite. Everyone logs in with their own account, and you control who is on each project.

Pretask runs on Microsoft Azure, the same secure cloud platform that runs much of the world’s enterprise software. Your data is not shared outside of the Pretask environment.  You log in with your existing Microsoft or Google account so there are no extra usernames or passwords to remember.  The only information we receive from Microsoft or Google is your name and email address in order to facilitate log in.

Request the free trial and our team will email login instructions. From there, upload your XER and the schedule opens right away.

California, USA.

More questions? Contact us
You won’t believe what we’re working on next
-David, CEO & Cofounder

Frictionless P6 Schedule Viewing and Collaboration

An accessible, standalone schedule collaboration tool for individuals and teams to view XERs and discuss changes in context. No P6 license required.

Sign up for waitlist
Up to 5 users · unlimited schedule revisions
Schedule Intelligence app: activity grid, Gantt, an open activity card, and the comments rail
Schedule Intelligence

Turn your P6 XER file into a shared working view, right from your browser.

Schedule Viewing
Revision Comparison
Share and collaborate
Schedule health
Update & export
Get answers faster

Search and filter activities, expand the WBS, inspect dates and float, and trace the logic driving any activity.  Save your views for easy access.

Learn more
Schedule Viewing

Get answers faster

Refined saved view: 7 of 212 activities with the Trace Logic panel
See what you need, follow the logic
Configurable saved views
Search
Group by WBS
Add and remove columns
Show critical path
Filter and sort
Filter by activity code
Trace logicLogic arrows
Revision Comparison

Compare revisions to understand what changed

Compare up to four revisions in the same screen.  Immediately see changes in dates, progress, activities, and logic.

Revision comparison: layered Gantt with the revision selector and Activity Changes panel
See the changes side by side

Show all changes to see every difference instantly. Click a flagged activity to see its dates, progress, and logic against the primary revision.

See activities added and removed

New scope in, deleted scope out. Both surface in the comparison.

Share and collaborate

Collaborate in one shared workspace

Comments drawer with activity threads

Review and discuss the P6 schedule, without needing Oracle Primavera P6 licenses.

Everyone on the same revision

Invite project partners to the exact schedule revision under review so each person starts from the same information.

Communicate with context

Keep every thread attached to the activity or WBS row it concerns rather than losing the discussion across email, PDFs, and meeting notes.

Schedule health

One click to know if the project finishes on time

Get instant validation scoring, risk identification, and critical path analysis with underlying reasons. Jump directly to the affected activities for additional context.

Health Check panel: DCMA 14-point results scrolled to the High Float finding
14 point DCMA check

Is this schedule mechanically credible?

LogicLeadsLagsRelationship typesHard constraintsHigh floatNegative floatHigh durationInvalid datesResourcesMissed tasksCritical path testCPLIBEI
Show more
8 additional risk checks

How serious are the problems and what is dragging the score down?

Soft constraints: ALAP, SNET, FNLT and other non-mandatory constraints on incomplete work.
Long FS lags: Finish-to-start ties with excessive lag that can mask intermediate work.
Riding data date: Incomplete activities with start dates anchored at the status date.
Out-of-sequence progress: Actual progress inconsistent with finish-to-start logic order.
Near-critical exposure: Incomplete activities within the near-critical float band.
Merge hotspots: Activities with high fan-in logic concentration.
Finisher path clarity: Advisory diagnostics on the acceptance and finish path.
Progress date inconsistency: Reported status or actual dates that conflict with the planned finish.
Show more
Critical Activities

Which specific activities warrant review first?

Know what to chase before the finish date slips. Schedule Intelligence ranks the activities deciding it and shows why each made the list. Jump straight to them in the Gantt, or take the list to your next meeting.

Show more
Update & export

Turn project inputs into usable schedule updates

Record status, percent complete, actual dates, and activity level context in a working revision. Save it, share it, and export an updated XER or meeting-ready PDF.

Editing status and dates, then exporting an updated XER
1
Capture progress

Update status, percent complete, and actual dates against the relevant activities.

2
Save a working revision

Save updates to the existing file, or save as a new revision so the original stays untouched.

3
Export XER or PDF

Return an updated XER to P6 or create a clear PDF for the next meeting.

ABOUT US
United States flag

Top tier operators from construction, tech, and AI.  $20B+ in impact to the construction environment.

David Kha
David Kha
David Kha on LinkedIn
Cofounder, CEO

A decade in SaaS, most recently at Revizto helping some of the largest AEC firms in the US  improve project delivery.

Jason Cho, PhD
Jason Cho, PhD
Jason Cho on LinkedIn
Cofounder, CTO

Ex-Director of Machine Learning at Walmart building their prediction technology. 20+ patents, now leading Pretask.AI's technical direction on predictive intelligence for AEC.

Chris Morris
Chris Morris
Chris Morris on LinkedIn
Advisor

Ex-Swinerton National VP (retired). Chris is now supplementing our domain expertise with his extensive construction executive experience.

Read more

Building predictive intelligence for the AEC industry

Pricing

Let's help you work and collaborate better.  Priced accessibly for everyone.

Standard
$14per user / month, billed annually
Great for individuals who just need to view schedules
Schedule Viewing
Revision Comparison
Update and export
Pro
$18per user / month, billed annually
For teams who need a collaborative environment
Everything in Standard
Share and collaborate
Schedule Health
Comments
1 new thread
David Kha
David Kha just now
CEO, Pretask.AI

Still thinking about it? Try it for free.

30 day free trial
Up to 5 users
One project
Unlimited schedule revisions
All features of Pro included
No credit card, no commitment

Try it on a live project.

Free 30-day trial · up to 5 users · unlimited schedule revisions

Sign up for waitlist
Don't need the trial?Sign up for waitlist
FAQ
Sure! Email us at sales@pretask.ai and we’ll get back to you right away.
XER is the export format Primavera P6 uses for schedules. If someone sent you “the schedule” as a file, it is probably an XER. Pretask opens it in your browser. No software to install.
No. Schedule Intelligence acts as the accessible view and collaboration tool for the broader project team where P6 is either too expensive or too complex to be practical for everyone on the project. You simply upload the P6 file (XER) and the full schedule opens in your browser. No P6 license, and no dedicated software to install.

Not for the scheduler responsible for building and maintaining the master schedule. P6 remains the system of record for schedule logic, calendars, sequencing, and formal schedule updates.

For the rest of the project team, Schedule Intelligence can replace the need to work directly in P6. Schedule Intelligence lets you review the schedule, trace logic, comment on activities, run health checks, and update status, percent complete, and actual start/finish dates without needing your own P6 license. Schedule Intelligence can then export an updated XER for the scheduler to review and continue maintaining in P6.

We currently support Primavera P6 XER files. If you’d like us to consider other formats, drop us a line at sales@pretask.ai.
Yes. Edit status, percent complete, and actual start/finish dates. Save your work as a revision and export an updated XER or a multi-page PDF.
Only people you invite. Everyone logs in with their own account, and you control workspace access.
Pretask runs on Microsoft Azure, the same secure cloud platform that runs much of the world’s enterprise software. Your data is not shared outside of the Pretask environment.  You log in with your existing Microsoft or Google account so there are no extra usernames or passwords to remember.  The only information we receive from Microsoft or Google is your name and email address in order to facilitate log in.
Request the free trial and our team will email login instructions. From there, upload your XER and the schedule opens right away.
California, USA.
More questions? Contact us
You won’t believe what we’re working on next
-David, CEO & Cofounder
